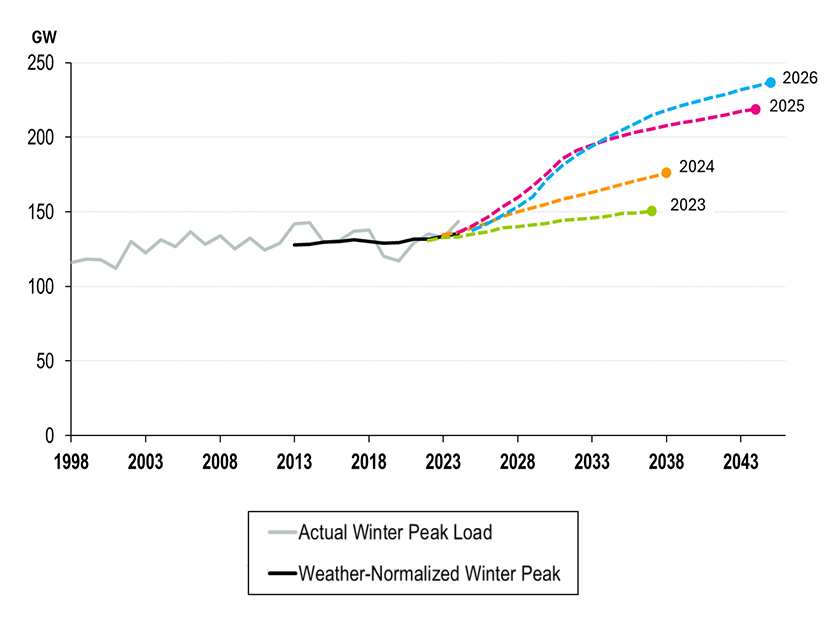

The PJM Interconnection, serving 65 million people across 13 Mid-Atlantic and Midwest states, faces an unprecedented infrastructure crisis as AI data center demand overwhelms the largest US power grid. PJM CEO David Mills released a 70-page white paper acknowledging the current operational model is "not tenable," requiring fundamental restructuring within years. The grid operator warned of potential electricity shortages as early as 2027, with capacity market prices exceeding 1,000% increases in recent auctions driven by 800+ new interconnection requests for 220 gigawatts of capacity. This crisis directly impacts e-commerce sellers through three mechanisms: rising electricity costs for fulfillment centers, potential service reliability degradation, and infrastructure investment uncertainty affecting regional logistics hubs.
The operational bottleneck stems from structural misalignment. PJM's three-year market commitment structure, designed for coal-to-natural-gas transitions, cannot accommodate solar and battery systems deployable in 6-12 months. Of 300+ gigawatts queued in 2022, only 23 gigawatts connected while most developers withdrew. Since reopening, PJM received 800+ requests, creating a "credibility trap" where price spikes trigger political intervention (Pennsylvania Governor Josh Shapiro imposed capacity price limits in 2024) that deters long-term power plant investments. Major utility American Electric Power (AEP) is considering withdrawing entirely, signaling systemic dysfunction. Natural gas turbine shortages delay plant installations until the early 2030s, with turbine prices skyrocketing due to hyperscaler demand.
For e-commerce sellers, this translates into three cost pressures. First, fulfillment center electricity costs will rise 8-15% annually through 2027 for sellers using AWS, Google Cloud, or Microsoft Azure-dependent logistics. Second, regional concentration risk affects sellers in Northern Virginia's data center hub and Mid-Atlantic states, where electricity prices may increase 20-30% relative to other US regions. Third, service reliability uncertainty creates operational risk for sellers dependent on cloud-based inventory management, order processing, and AI-powered recommendation engines. The grid operator proposed three reform pathways: long-term fixed-rate contracts (favoring large utilities), tiered reliability guarantees (creating premium/standard service tiers), or real-time market transitions. Each faces obstacles—longer commitments conflict with renewable deployment speed, tiered service creates political backlash, and real-time markets risk satisfying no stakeholders. Implementation timelines remain undefined pending stakeholder engagement through 2025-2026.
